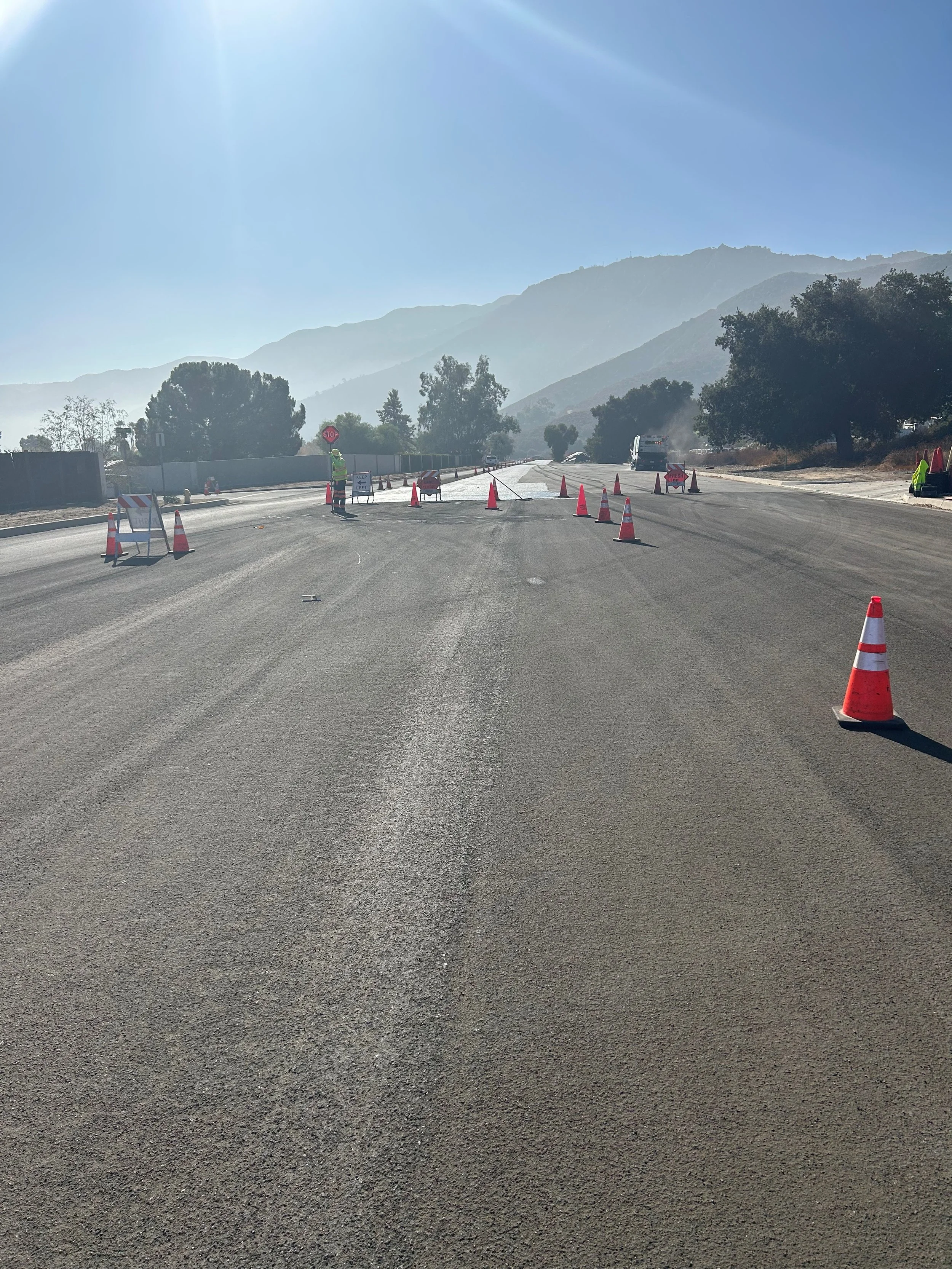

Slurry Seal FY24-25 District 1,2,3 - Weekly Status

- Repair/upgrade curb ramp throughout the project to meet ADA standard is completed.

- Weed Abatement in Districts 1,2 and 3 is completed.

- Type I and II slurry seal in the Woodcrest area is completed.

- Type I and Type II MSE in the Temescal Valley area is completed.

- Pavement Markings and the Second coat of striping in the Murrieta Hot Springs has been completed.

- Asphalt repairs throughout the project have been completed.

- Chip seal in the Highgrove area has been completed.

- Crews will place type 1 & 2 slurry seal in Highgrove area over the chip seal.

- Crews will begin the placement of the Type II slurry seal on La Sierra and Blackburn.

- Striping and pavement markings will continue to be installed in the Temescal Canyon area and Riverside area.

- Raised pavement markers (RPM) are being installing throughout the project.

- Crews will continue with the application of Type I & II in the Highgrove and Riverside area.

- Crews will continue with post sweeping throughout the project.

- Please use caution, observe construction warning signs, and follow traffic control staff’s directions while travelling through the work zone. Thank you for your patience and understanding.



Steven Grayslurryseal
Slurry Seal FY24-25 District 1,2,3 - Weekly Status

Slurry Seal FY24-25 District 1,2,3 - Weekly Status



- Repair/upgrade curb ramp throughout the project to meet ADA standard is completed.

- Weed Abatement in Districts 1,2 and 3 is completed.

- Type I and II slurry seal in the Woodcrest area is completed.

- Type I and Type II MSE in the Temescal Valley area is completed.

- Pavement Markings and the Second coat of striping in the Murrieta Hot Springs has been completed.

- Asphalt repairs throughout the project have been completed.

- Chip seal in the Highgrove area has been completed.

- Crews will place type 1 & 2 slurry seal in Highgrove area over the chip seal.

- Crews will begin the placement of the Type II slurry seal on La Sierra and Blackburn.

- Striping and pavement markings will continue to be installed in the Temescal Canyon area.

- Crews will continue with the application of Type I & II in the Highgrove and Riverside area.

- Crews will start and complete the application of the MSE Type II in Lake Elsinore area.

- Crews will continue with post sweeping throughout the project.

- Please use caution, observe construction warning signs, and follow traffic control staff’s directions while travelling through the work zone. Thank you for your patience and understanding.



Steven Grayslurryseal
Slurry Seal FY24-25 District 4 & 5 - Weekly Status Update

Slurry Seal FY24-25 District 4,5 - Weekly Status Update


- Crack seal treatment continued w/two crews in Palm Desert to stay ahead of slurry team.

- Type 2 slurry seal work changed from Cabazon to Hemet.

- Crew worked on Saturday doing Type 2 slurry seal in Thousand Palms.

- CTI finished all striping punch list items at Lake Cahuilla. Just need water valve cover cleaned and load of excavated garbage removed to close out D5-0017.

- Two Crack seal crews scheduled for Saturday and Sunday in Redlands.

- Two crack seal crews and one slurry crew scheduled to continue Monday in Hemet.

- Please use caution, observe construction warning signs, and follow traffic control staff’s directions while travelling through the work zone. Thank you for your patience and understanding.


Steven Grayslurryseal
Slurry Seal FY24-25 District 4 & 5 - Weekly Status

Slurry Seal FY24-25 District 4 & 5 - Weekly Status

- Crack seal treatment continued with two crews in Thousand Palms to stay ahead of slurry team.

- Wide crack AC repairs completed in Redlands. Item 20 AC Surfacing now complete.

- Type 1 slurry seal work began in Thousand Palms.

- Type 2 slurry seal scheduled for Saturday in Thousand Palms.

- Type 2 slurry seal scheduled for Saturday in Cabazon.

- Two crack seal crews and one slurry crew scheduled to continue Monday in Thousand Palms.

- Please use caution, observe construction warning signs, and follow traffic control staff’s directions while travelling through the work zone. Thank you for your patience and understanding.

Steven Grayslurryseal
Slurry Seal FY24-25 District 1,2,3 - Weekly Status

Slurry Seal FY24-25 District 1,2,3 - Weekly Status

- Repair/upgrade curb ramp throughout the project to meet ADA standard is completed.

- Weed Abatement in Districts 1,2 and 3 is completed.

- Type I and II slurry seal in the Woodcrest area is completed.

- Type I and Type II MSE in the Temescal Valley area is completed.

- Pavement Markings and the Second coat of striping in the Murrieta Hot Springs has been completed.

- Asphalt repairs throughout the project have been completed.

- Chip seal in the Highgrove area has been completed.

- Crews will place type 1 & 2 slurry seal in Highgrove area over the chip seal.

- Crews will continue with post sweeping throughout the project.

- Striping and pavement markings will continue to be installed in the Woodcrest and Temescal Canyon area.

- Please use caution, observe construction warning signs, and follow traffic control staff’s directions while travelling through the work zone. Thank you for your patience and understanding.

Steven Grayslurryseal
Slurry Seal FY24-25 District 1,2,3 - Weekly Status

- Repair/upgrade curb ramp throughout the project to meet ADA standard is completed.

- Weed Abatement in Districts 1,2 and 3 is completed.

- Type I and II slurry seal in the Woodcrest area is completed.

- Type I and Type II MSE in the Temescal Valley area is completed.

- Pavement Markings and the Second coat of striping in the Murrieta Hot Springs has been completed.

- Asphalt repairs throughout the project have been completed.

- The crews will place chip seal in the Highgrove area.

- Lead crews will continue with post sweeping throughout the project.

- Striping and pavement markings will continue to be installed in the Woodcrest and Hemet area.

- Please use caution, observe construction warning signs, and follow traffic control staff’s directions while travelling through the work zone. Thank you for your patience and understanding.



Steven Grayslurryseal
